Hybrid Project Management Playbook¶

Role: Project Manager / Scrum Master Time Required: Ongoing (Weekly Sync) Participants: Product Owner, Project Manager, Tech Lead Difficulty: Advanced
🎯 Objective¶
To successfully manage the "Interface" between Agile delivery teams (Scrum/Kanban) and Waterfall governance layers (Finance/Executive), ensuring compliance without sacrificing agility.
📋 Prerequisites¶
- [ ] Master Project Schedule (Gantt) defined
- [ ] Team Backlog (Jira/Azure DevOps) prioritized
- [ ] Logical mapping between "Epics" and "Milestones"
📝 The Script (Execution Guide)¶
1. The Interface Sync (Weekly)¶
Facilitator Script:
"We are here to map our verified velocity against the firm milestones. Let's identify where the 'Red lines' of the Gantt chart are conflicting with our current Sprint reality."

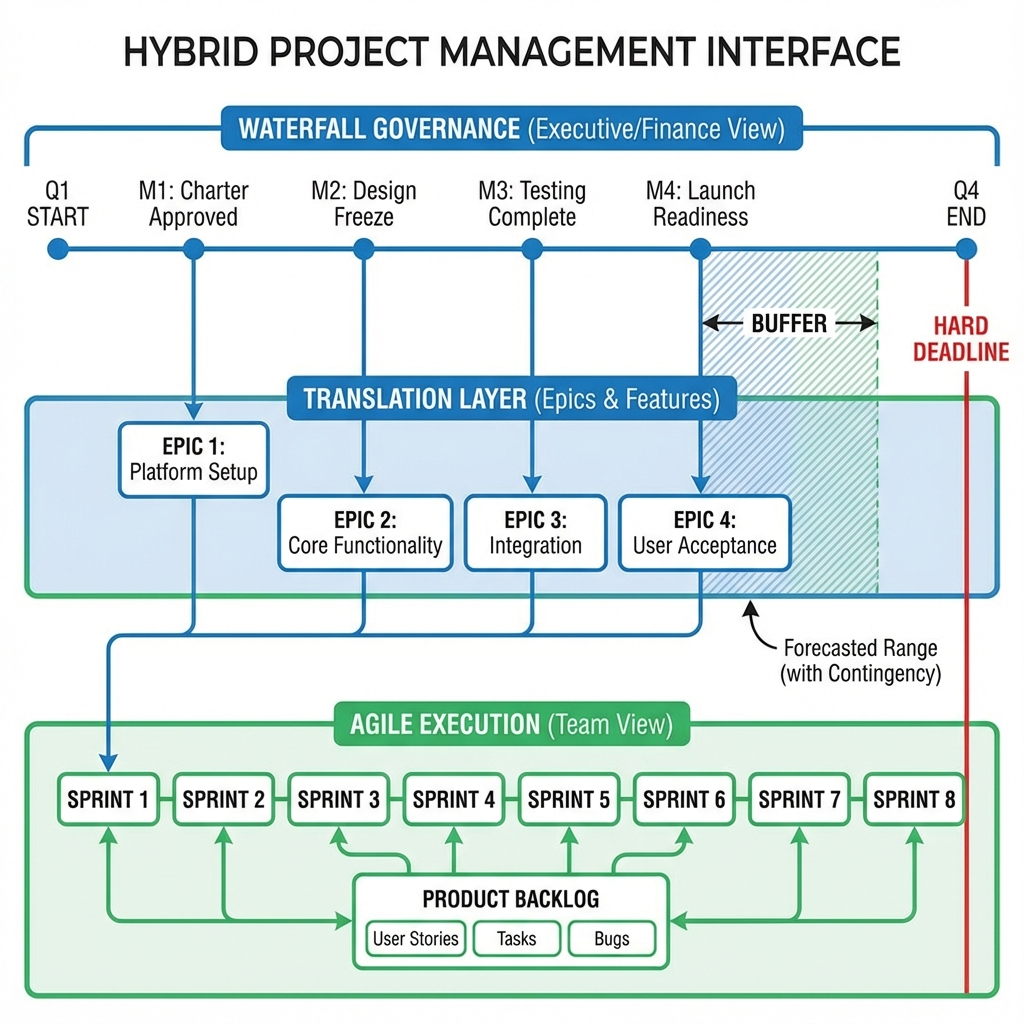

2. The Core Activity: Mapping Backlog to Gantt¶
Activity A: Translation Layer¶
- Instruction: Map every Agile Epic to a WBS (Work Breakdown Structure) element.
- Agile: "User Registration Feature" (Epic)
- Waterfall: "Phase 2.1: Identity Module Complete" (Milestone)
- Rule: Never map individual User Stories to the Gantt chart. Only map Epics or Features.
Activity B: The Buffer Management¶
- Instruction: Explicitly visualize the "buffer" between the fixed date and the forecasted delivery range.
- Facilitator Tip: If the forecasted range (based on velocity) exceeds the milestone date, trigger a "Trade-off Conversation" immediately. Do not wait.
3. Closing¶
Facilitator Script:
"We have flagged 2 risks where the scope is creeping beyond the timeline. I will update the risk register for the steering committee. Team, keep focusing on the sprint goal."
🛠️ Tools & Templates¶
- Jira Advanced Roadmaps: Use "Fix Version" to map to Gantt milestones.
- MS Project: Utilize "Summary Tasks" to represent Agile Epics.
⚠️ Common Pitfalls¶
- Pitfall 1: Micro-managing the team with Gantt dates.
- Solution: Only expose the "Milestone" date to the team as a constraint, don't dictate the daily schedule.
- Pitfall 2: "Water-Scrum-Fall" (Agile dev, defined reqs, manual testing).
- Solution: Invest heavily in DevOps to automating testing, allowing the "Scrum" part to actually finish "Done" increment.
🧠 First Principles¶
Hybrid is not a compromise; it's a Risk Management Strategy. * Waterfall manages Financial Risk (Cost/Schedule). * Agile manages Technical/Market Risk (Feasibility/Fit). * The "Hybrid" model is simply the protocol for exchanging information between these two risk domains.
