Hybrid Project Management Playbook¶

Role: Project Manager / Scrum Master Time Required: Ongoing (Weekly Sync) Participants: Product Owner, Project Manager, Tech Lead Difficulty: Advanced
Key takeaways
- Hybrid = agile teams inside waterfall governance: sprints for delivery, milestones and budgets for executives.
- Map epics, not stories, to milestones: keep the Gantt chart at the level of features and phases.
- Forecast with real velocity and show a delivery range, not a single date.
- Trigger trade-off conversations early when the forecast range crosses a fixed milestone.
- Avoid water-scrum-fall by automating testing so sprints produce truly done increments.
🎯 Objective¶
To successfully manage the "Interface" between Agile delivery teams (Scrum/Kanban) and Waterfall governance layers (Finance/Executive), ensuring compliance without sacrificing agility.
📋 Prerequisites¶
- Master Project Schedule (Gantt) defined
- Team Backlog (Jira/Azure DevOps) prioritized
- Logical mapping between "Epics" and "Milestones"
📝 The Script (Execution Guide)¶
1. The Interface Sync (Weekly)¶
Facilitator Script:
"We are here to map our verified velocity against the firm milestones. Let's identify where the 'Red lines' of the Gantt chart are conflicting with our current Sprint reality."

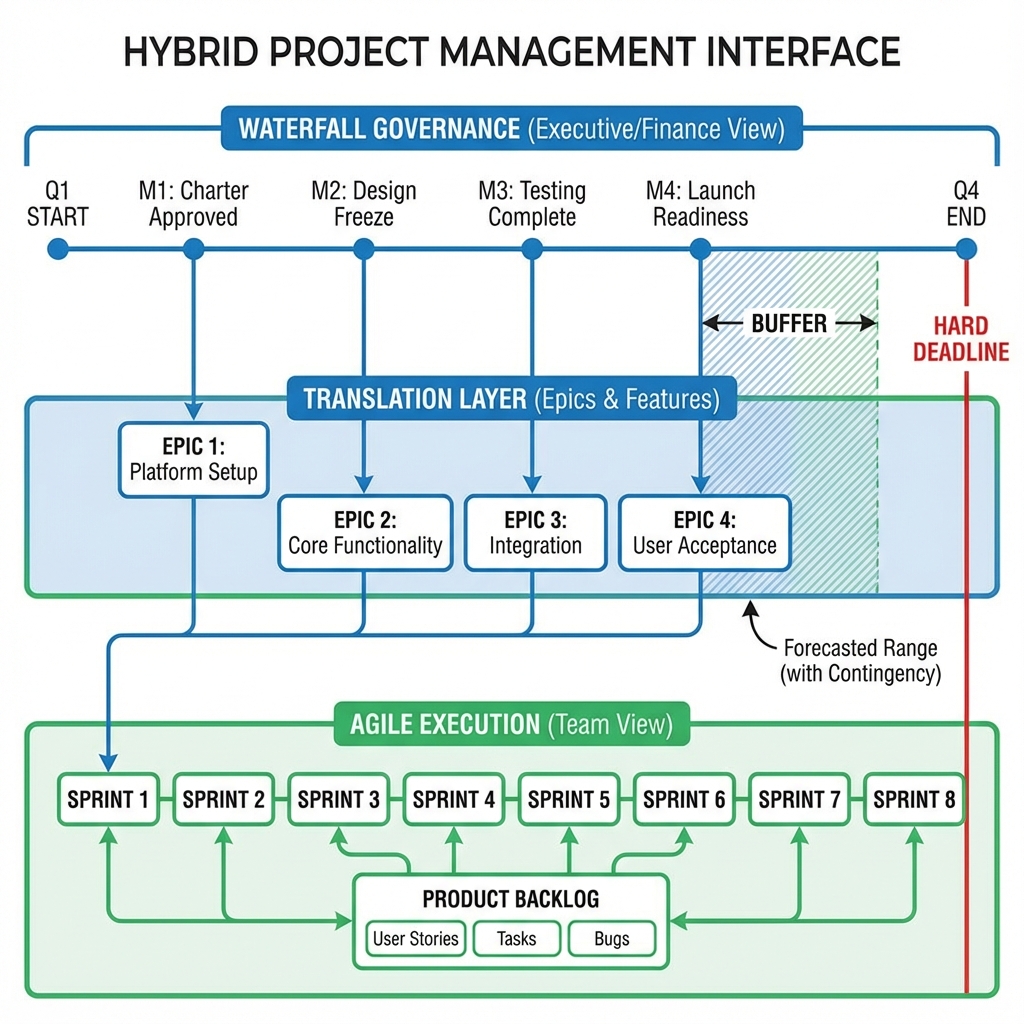

2. The Core Activity: Mapping Backlog to Gantt¶
Activity A: Translation Layer¶
- Instruction: Map every Agile Epic to a WBS (Work Breakdown Structure) element.
- Agile: "User Registration Feature" (Epic)
- Waterfall: "Phase 2.1: Identity Module Complete" (Milestone)
- Rule: Never map individual User Stories to the Gantt chart. Only map Epics or Features.
Activity B: The Buffer Management¶
- Instruction: Explicitly visualize the "buffer" between the fixed date and the forecasted delivery range.
- Facilitator Tip: If the forecasted range (based on velocity) exceeds the milestone date, trigger a "Trade-off Conversation" immediately. Do not wait.
3. Closing¶
Facilitator Script:
"We have flagged 2 risks where the scope is creeping beyond the timeline. I will update the risk register for the steering committee. Team, keep focusing on the sprint goal."
🛠️ Tools & Templates¶
- Jira Advanced Roadmaps: Use "Fix Version" to map to Gantt milestones.
- MS Project: Utilize "Summary Tasks" to represent Agile Epics.
⚠️ Common Pitfalls¶
- Pitfall 1: Micro-managing the team with Gantt dates.
- Solution: Only expose the "Milestone" date to the team as a constraint, don't dictate the daily schedule.
- Pitfall 2: "Water-Scrum-Fall" (Agile dev, defined reqs, manual testing).
- Solution: Invest heavily in DevOps to automating testing, allowing the "Scrum" part to actually finish "Done" increment.
🧠 First Principles¶
Hybrid is not a compromise; it's a Risk Management Strategy.
- Waterfall manages Financial Risk (Cost/Schedule).
- Agile manages Technical/Market Risk (Feasibility/Fit).
- The "Hybrid" model is simply the protocol for exchanging information between these two risk domains.
When Does Hybrid Make Sense?¶
| Situation | Why hybrid helps |
|---|---|
| Fixed regulatory or contractual deadlines | Milestones are non-negotiable, but the work to reach them benefits from iteration |
| Hardware + software projects | Hardware has long lead times and stage gates; software can iterate |
| Large organizations with annual budgeting | Funding is approved by phase, while teams deliver in sprints |
| Vendor-managed components | External parties work to fixed scopes and dates |
Interface Sync Agenda (30 minutes, weekly)¶
| Time | Item |
|---|---|
| 5 min | Velocity trend and forecast range for each epic |
| 10 min | Milestones at risk: where does the forecast range cross a fixed date? |
| 10 min | Trade-offs: scope, date, or resources; decide or escalate |
| 5 min | Update the risk register and the summary for the steering committee |
Frequently Asked Questions¶
Is hybrid project management just a compromise?
Not necessarily. Waterfall governance manages financial and schedule risk; agile delivery manages technical and market risk. Hybrid is a protocol for exchanging information between the two.
What is water-scrum-fall?
A pattern where requirements are fixed upfront (waterfall), development happens in sprints (scrum), and testing and release happen in a big batch at the end (waterfall again). It brings the overhead of agile without its benefits.
How do I report agile progress to executives who expect Gantt charts?
Map epics to milestone tasks, show percent complete by finished features rather than hours spent, and present a forecast range based on velocity.
Extensions and Connections¶
- Agile: The values and frameworks behind the delivery side of a hybrid model.
- Scrum: Sprints, velocity and increments that feed milestone forecasts.
- Kanban: An alternative delivery approach for teams with continuous incoming work.
- RACI Matrix: Clarifying who decides at the interface between governance and delivery.
